C&I installer’s battery storage playbook for 2026
Storage has moved from add-on to anchor. Here is how to build the muscle to develop and install commercial battery projects.

By Tim Montague | For most of the last decade, C&I solar installers treated battery storage as a value-add. That era is over. In 2026, storage is becoming THE DEAL at a growing share of C&I sites, and in high-demand-charge territories the battery often delivers more economic value than the PV array above it. Self-developing these projects, originating the customer, structuring the financing, and controlling the work through commissioning, is where the value sits.
The 3 forces driving the shift
Demand charges. For mid-to-large commercial customers, peak demand charges can run 30 to 70 percent of the monthly bill. A properly sized battery can shave peak demand by 20 to 50 percent, with total bill reductions of 10 to 20 percent typical once demand-charge management and time-of-use arbitrage are both modeled.
Resiliency. Reliability is what you do when the grid is up, and that is what VPPs compensate for. Resilience is what you do when the grid goes down, and there is currently no US market mechanism that pays for it as a service.

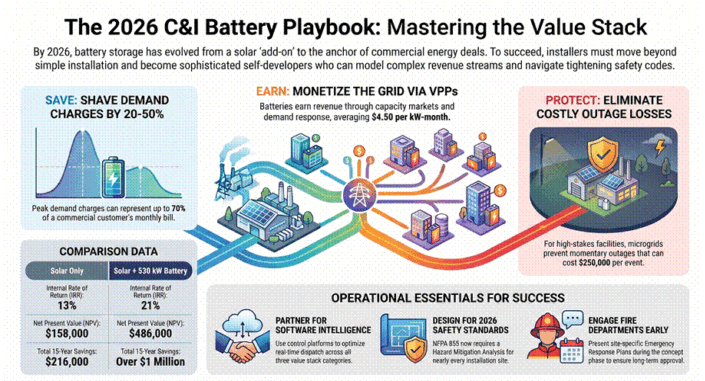

The value stack: Earn, Save, Protect
The clearest way to frame battery storage for a C&I customer is through three questions: What can it earn? What can it save? and…What does it protect?
Earn covers revenue from wholesale and grid services markets. In California, ISO-NE, NYISO, and PJM, behind-the-meter batteries can monetize capacity markets, demand response programs, and ancillary services like frequency regulation and spinning reserves. In California, that stack includes Demand Side Grid Support, Base Interruptible Program, and Emergency Load Reduction Program, plus resource adequacy contracts with CCAs (community choice aggregators) or IOUs. Resource adequacy works like this: the battery owner commits to making a set number of kilowatts available during peak periods, and the CCA or IOU pays a monthly fee per kilowatt of committed capacity. Practitioners are pricing that at roughly $4.50 per kW-month, though real-world performance runs closer to 90 percent of headline capacity, so model the discount.
Save is often where the largest dollars live. A well-sized battery with good control software can shave demand peaks systematically, and the savings compound when you layer in time-of-use optimization and increased solar self-consumption. A 250 kW solar-only project in Rockford, Illinois (PJM territory) carried a 4.3-year payback and $215K ROI. Adding a 530 kW battery pushed IRR from 13 percent to 21 percent, grew NPV from $158K to $486K, and lifted total 15-year savings from $216K to over $1 million.
Protect is where the conversation often closes. G&W Electric in the Chicago area was absorbing up to $250K per momentary outage, with as many as 12 per year. A solar, battery, and flywheel microgrid eliminated those losses entirely. Backup power and islanding value are highly site-specific, but for the right customer they dwarf every other line in the pro forma.
Optimizing across all three categories requires load profile analysis at the 8,760-hour level, precise system sizing, and control algorithms that most EPCs cannot model alone. Software and analytics partnerships are now part of the product.
Building the business around storage
Adding storage to your practice is not a product decision, it is an operational one. Here is what restructuring around it looks like.
Storage design and engineering. Work closely with SaaS partners and specialist integrators to understand which load profiles will pencil and how to size systems relative to facility load and any existing solar.
Financing. Start with the host’s existing banking relationships for host-owned deals, and know which green banks to engage if their lender won’t finance it. Third-party ownership is also viable, with the TPO offering an energy services agreement structured similarly to a solar PPA. Standing relationships with tax equity providers and TPO financiers give you flexibility when the deal requires it.
Code and safety. NFPA 855 (2026 edition) now requires a Hazard Mitigation Analysis on essentially every site. NFPA 69 is now the basis of design for explosion control, replacing NFPA 68. UL 9540A adds a Large-Scale Fire Test at the installation level. Most states are still on the 2020 edition, but siting boards increasingly ask for current-edition compliance, so reference both in your documentation.
Subcontractor bench. Qualified commercial electricians and commissioning engineers are constrained and tightening. Lock in strong subs with battery experience now.
Vertical focus. Pick two or three markets and go deep. Generalists lose to specialists in commercial work.
Engage the fire department early
Fire department engagement belongs at concept and pre-application, not commissioning. The fire chief has to answer questions about your project to their community for the twenty-year life of the system, and showing up at the eleventh hour with an OEM brochure is the fastest way to turn a neutral chief into an opponent. The Emergency Response Plan must be site-specific, operationally usable at 2 AM in the rain, and short enough to actually get read.
Expect questions about battery fires like Moss Landing, Warwick, and McMicken at public hearings. Engage them factually and drop the “this product cannot fail” pitch. It also helps to know your chemistry: LFP is now the dominant cell technology in C&I storage and is meaningfully less prone to thermal runaway than NMC. That is a legitimate and honest part of the story to tell.
Self-develop the Pproject
Treat every opportunity like a small development deal. Qualify from 12 months of interval data and the rate tariff before the site visit. Most installers new to storage default to a simple demand charge reduction model and size accordingly. That gets you a number, but it is often the wrong number and it leaves revenue on the table.
The sophisticated approach stacks all three use cases in the same model. Demand charge management, backup duration, and VPP participation each pull the system design in a different direction, and getting it wrong in either direction costs the customer money. Oversize for backup and you overspend on hardware. Undersize for VPP and you leave annual revenue uncaptured. The pro forma is where those trade-offs get resolved.
The other half of self-development is the software layer. Earning, saving, and protecting simultaneously requires a control platform that optimizes across all three in real time. That means partnering with a BESS software or VPP aggregation company that brings load forecasting, dispatch algorithms, and market enrollment under one roof. The battery is the hardware; the software is what makes the value stack perform.
The deeper shift is identity
Installers who build storage self-development competency are not adding a product line. They are becoming distributed energy infrastructure developers, with recurring customer relationships, grid services revenue, and long-term energy management responsibilities. Companies that make the transition this year define their book of business for the next decade. The rest subcontract to them.
About the author: Tim Montague is president of Clean Power Consulting Group and host of the Clean Power Hour podcast, with 400+ episodes interviewing leading practitioners in solar, storage, and clean energy. He advises solar EPCs and developers on scaling into C&I solar and storage markets. He is a WSI-Certified AI Consultant, HeatSpring instructor, and author of Wired for Sun: The Commercial Solar Playbook (2025). Reach him at tim@cleanpowerhour.com
